Welcome

The Future of I-270 is Taking Shape!

Welcome. The future of I-270 is taking shape. We appreciate your participation in this virtual open house. CDOT has analyzed two operating options considered for I-270 — General Purpose Lanes and Express Lanes — and has identified Express Lanes as part of the Preferred Alternative for improving I-270. We look forward to receiving your input on all elements of the Preferred Alternative presented in the information below.

To activate closed captions, click on the “CC” button at the bottom of the video window. Or, click the gear icon to change language settings.

VIDEO TRANSCRIPT

Hello and welcome to our virtual open house. I-270 is the most congested freeway in the state of Colorado.  CDOT is looking forward to making improvements in this corridor to better accommodate many forms of transportation. If you missed our previous virtual events in 2020 you can get up to speed by viewing past meeting contents on the project website at the link in the presentation below this video. Scroll through our open house and read through the information below to learn about community commitments, project design details and the project schedule. Express Lanes are included in the Preferred Alternative. Analysis and support for this decision is included in the detailed comparison with a traditional general purpose lane. When you see information that you have a question about or would like to provide input on, use the comment box below each display to submit your question or comment. If you’d like to stay informed in the future, scroll to the bottom of this open house site to sign up for email updates. Thank you for helping us shape the future of the I-270 corridor.

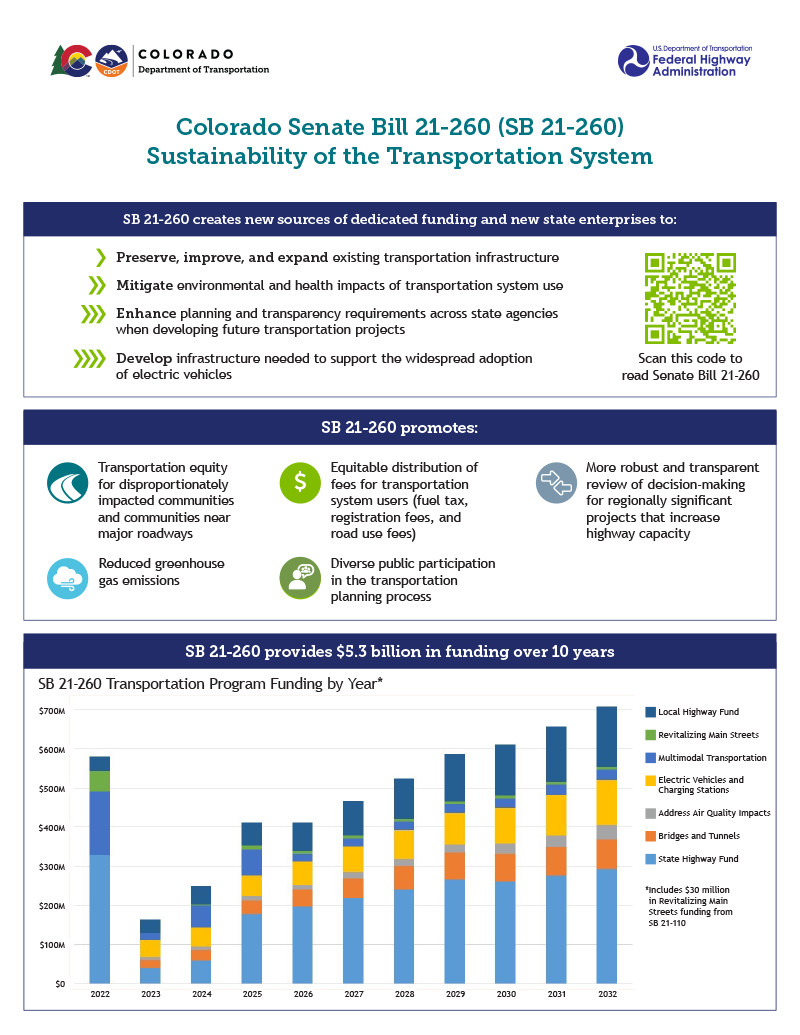

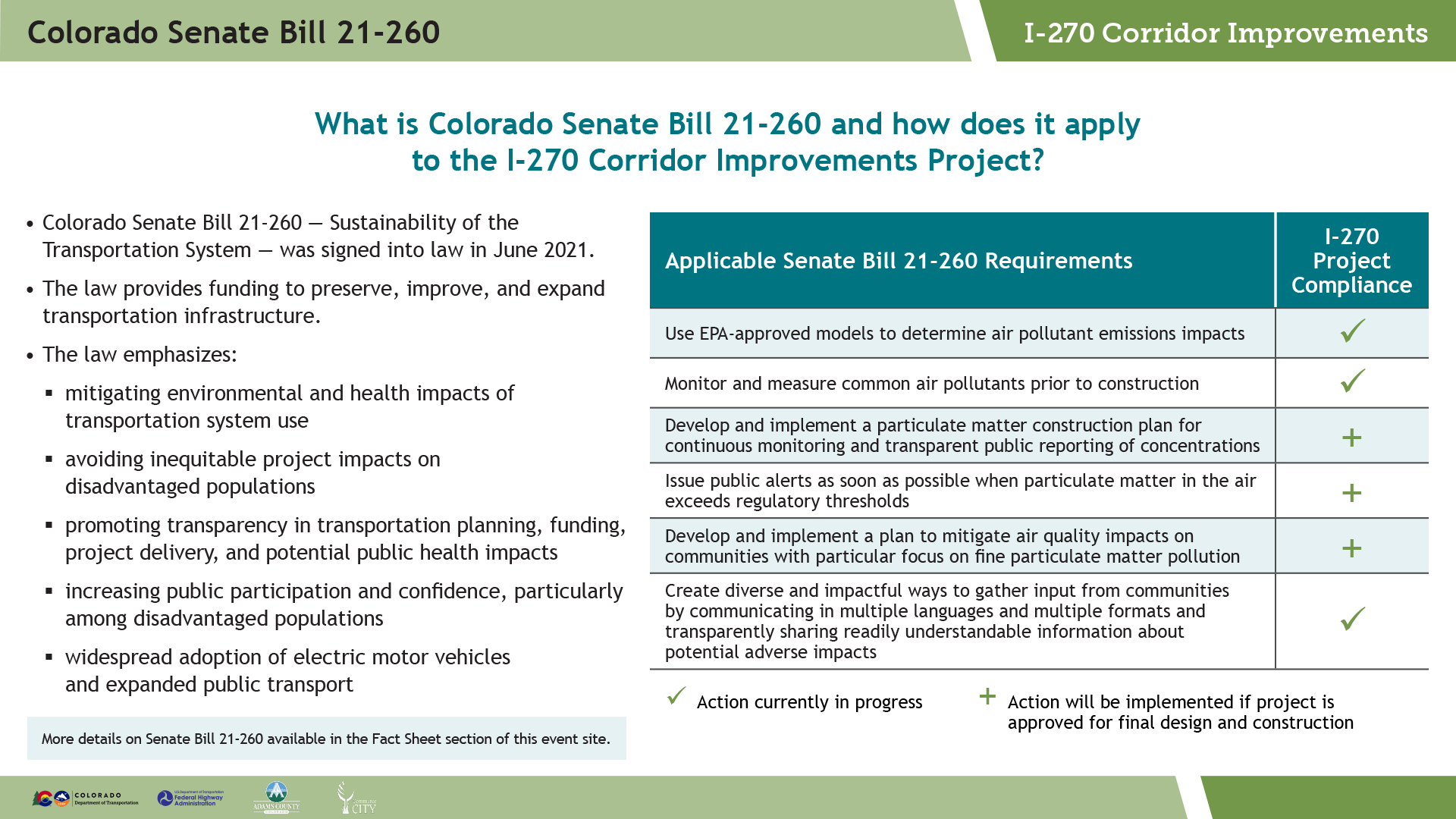

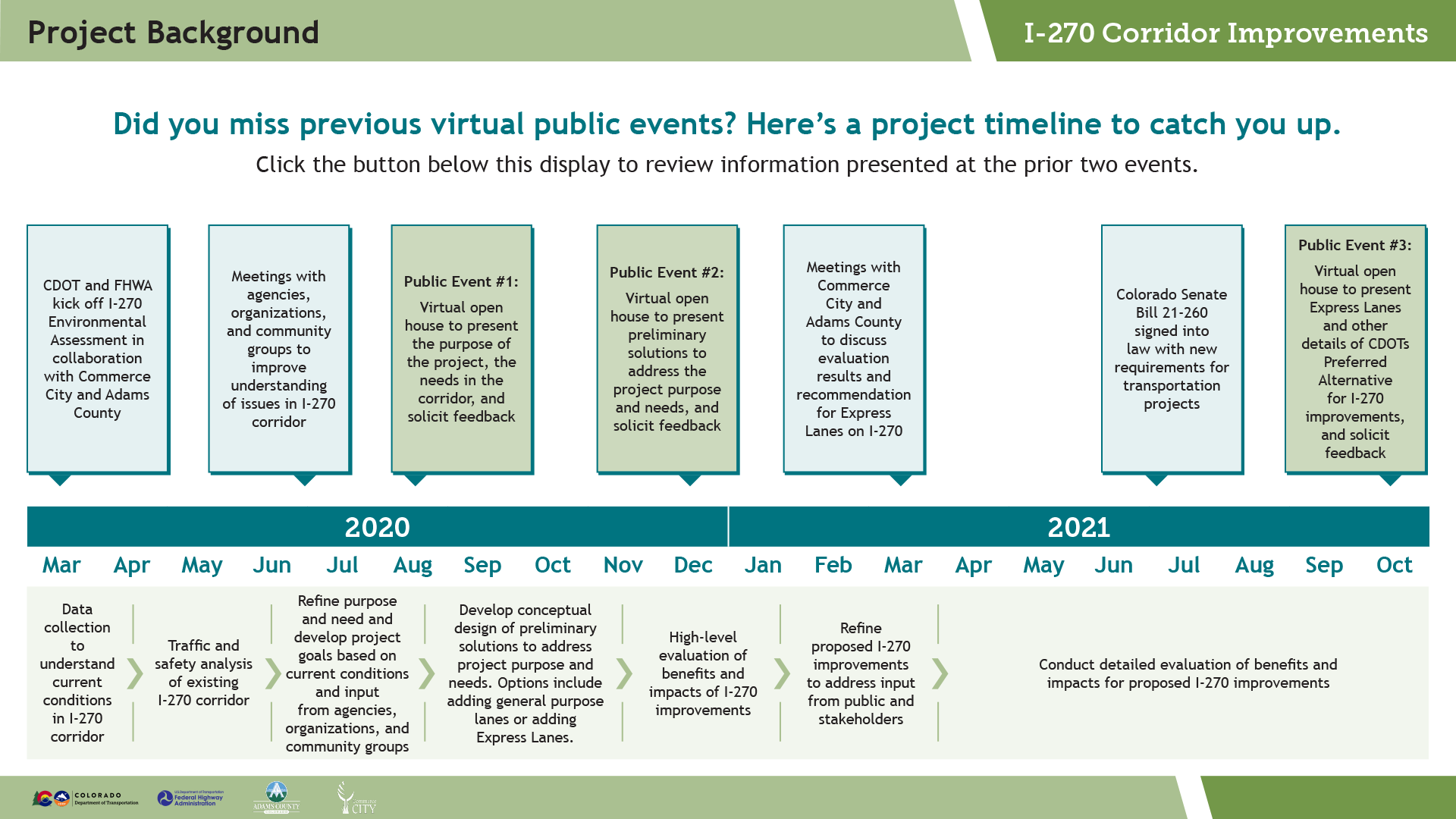

PROJECT BACKGROUND AND SENATE BILL 21-260

Click on the arrows next to the boards to scroll through the 3 boards in this section.

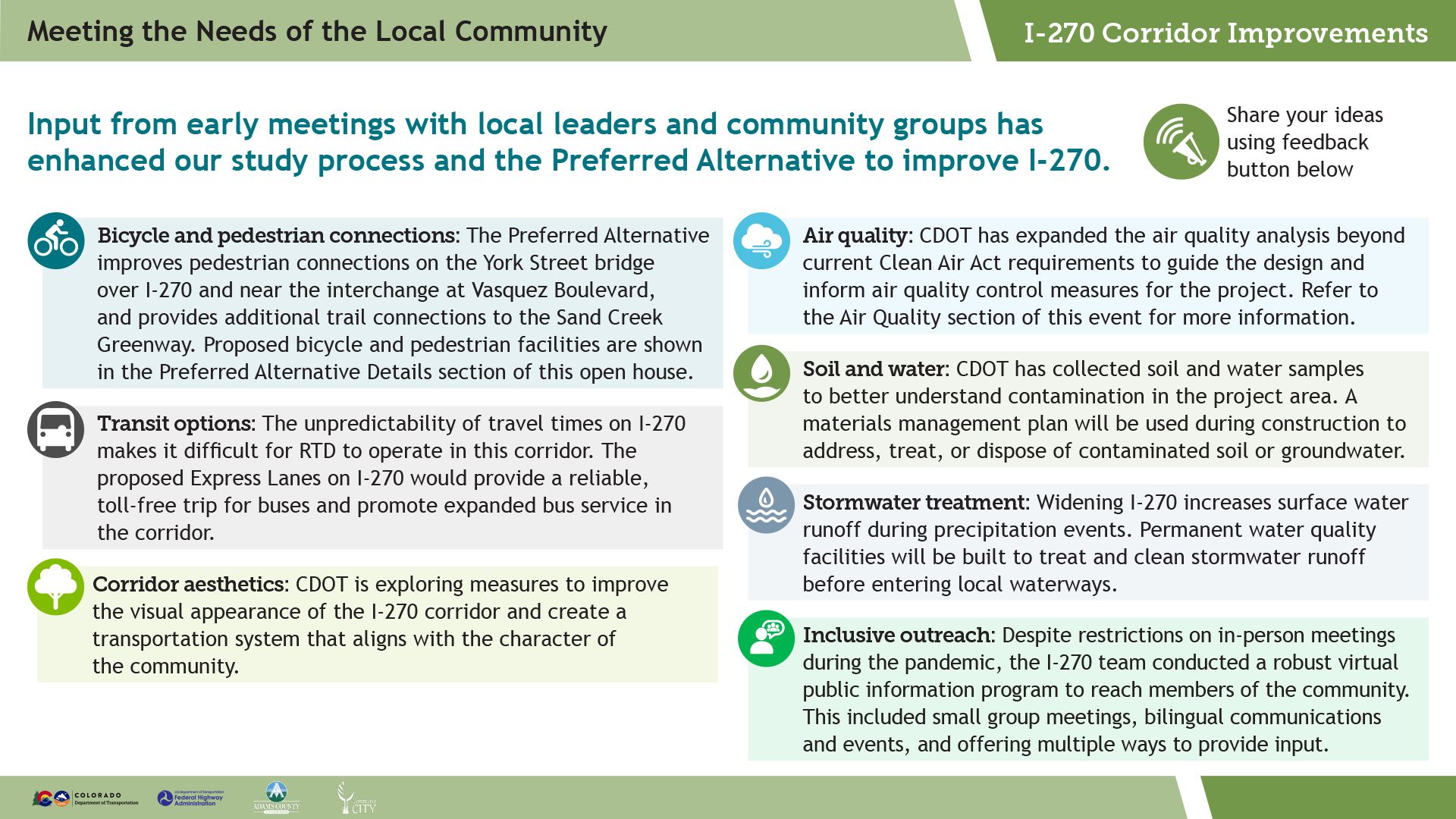

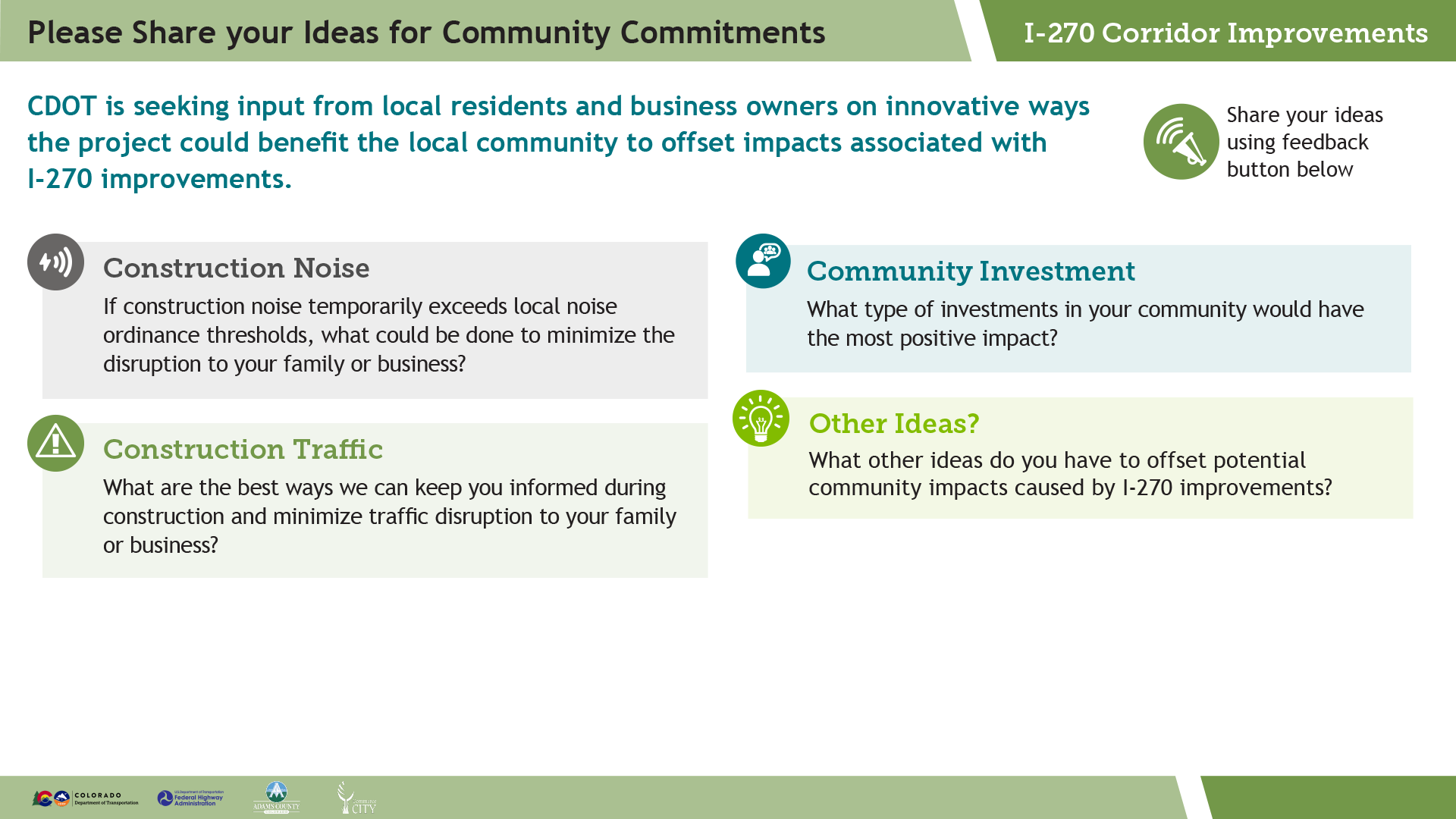

COMMUNITY COMMITMENTS

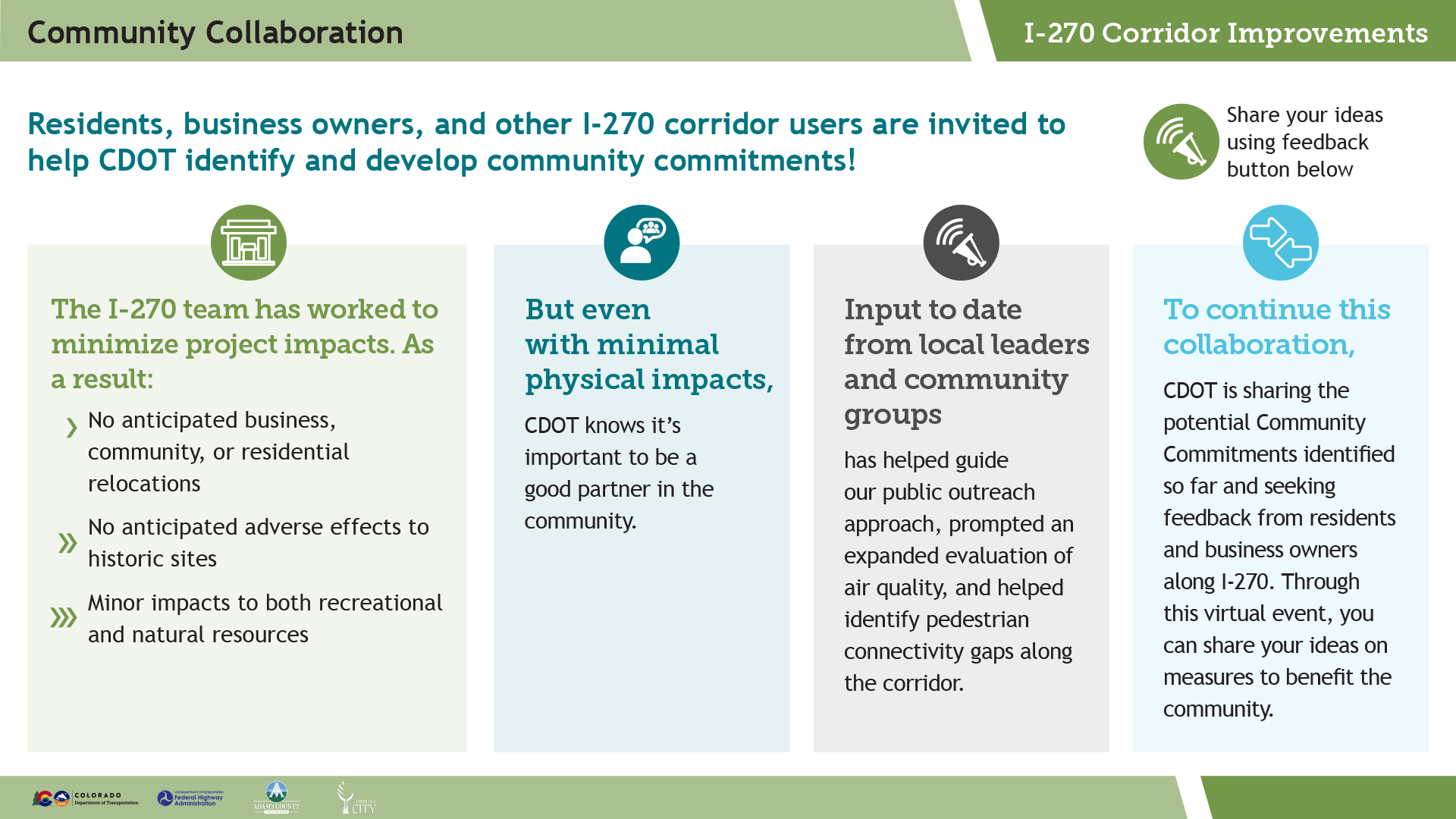

Click on the arrows next to the boards to scroll through the 3 boards in this section.

Enlarge image Click the image above to enlarge.

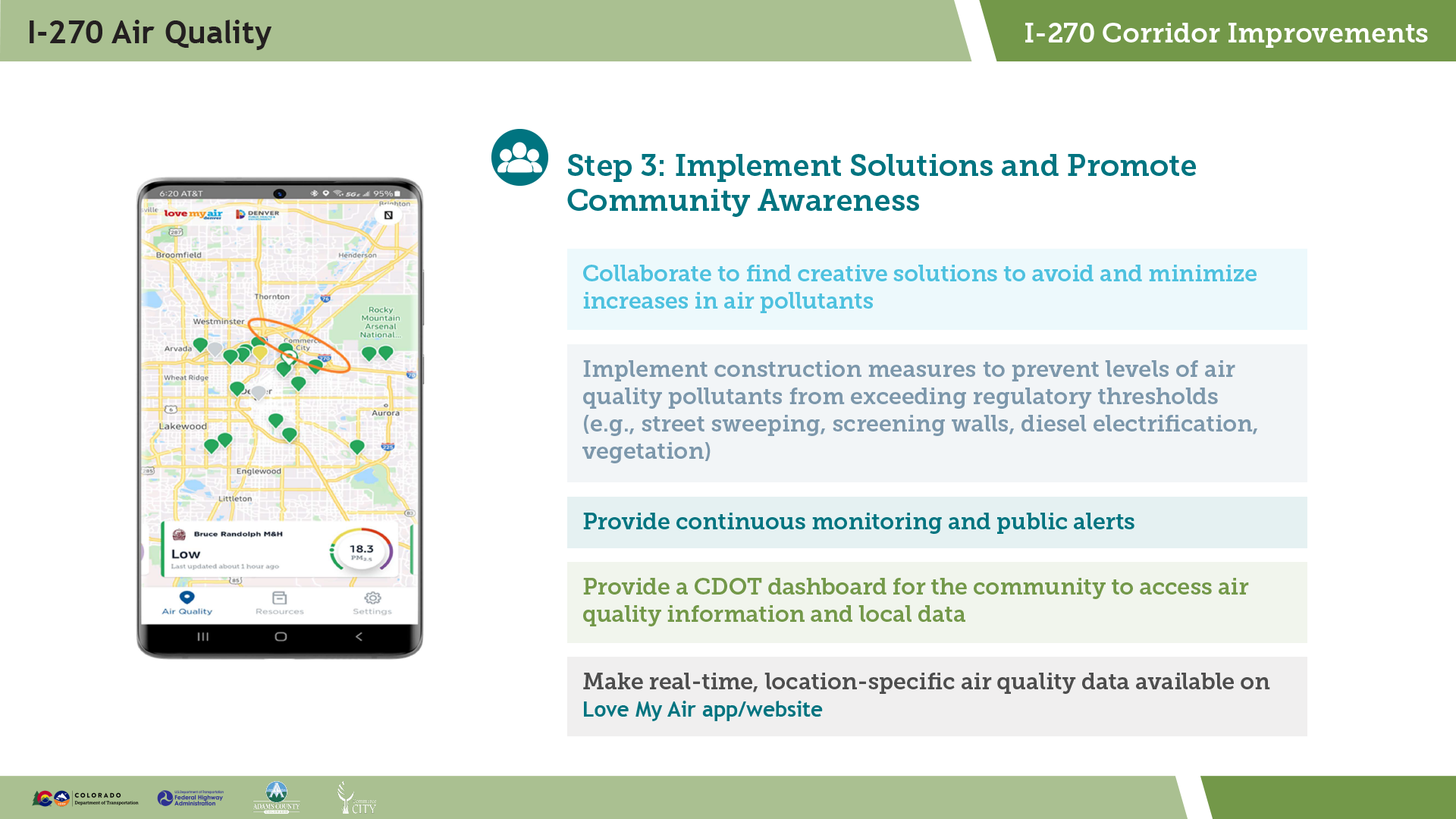

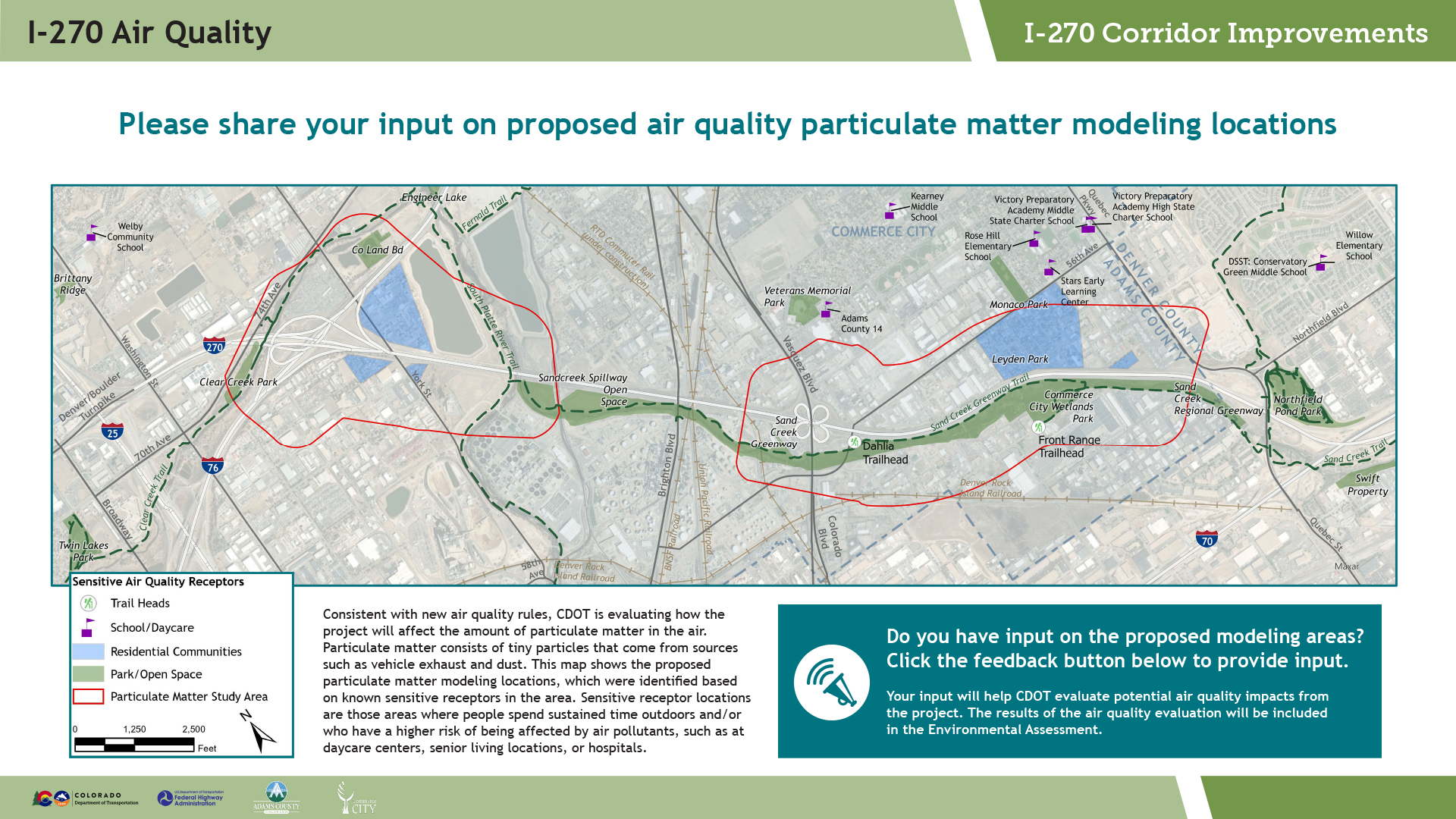

I-270 Air Quality

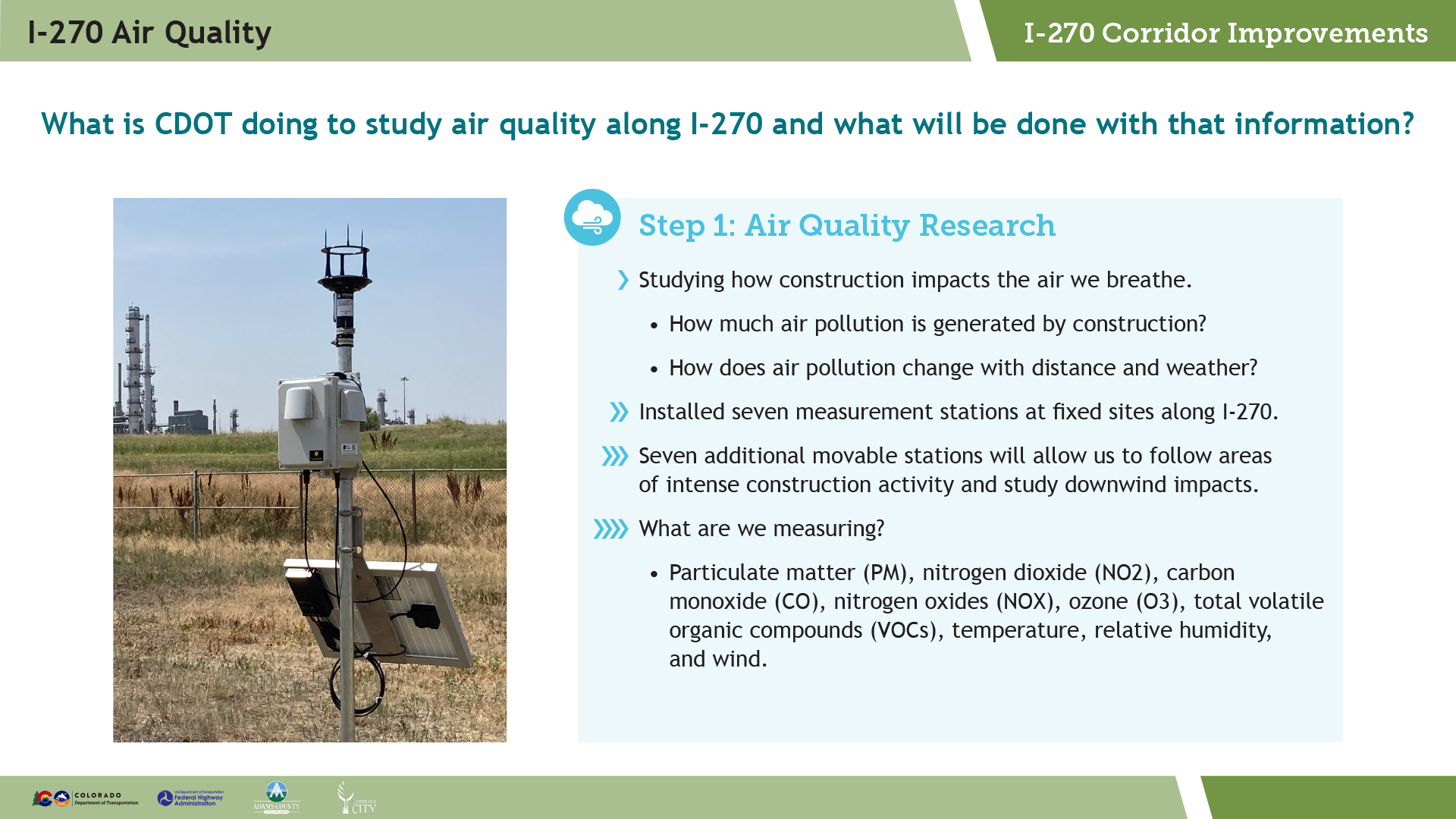

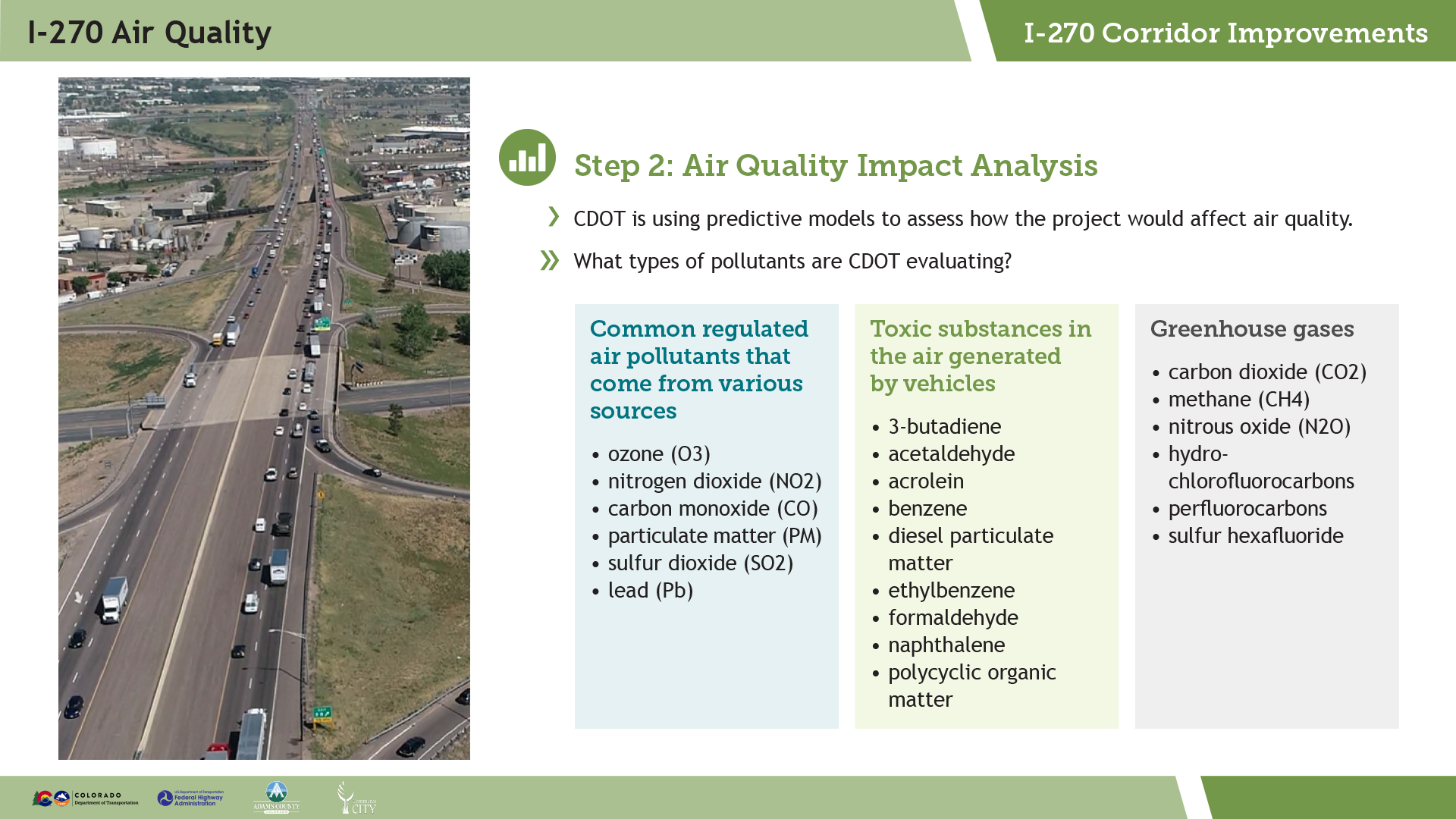

Click on the arrows next to the boards to scroll through the 4 boards in this section.

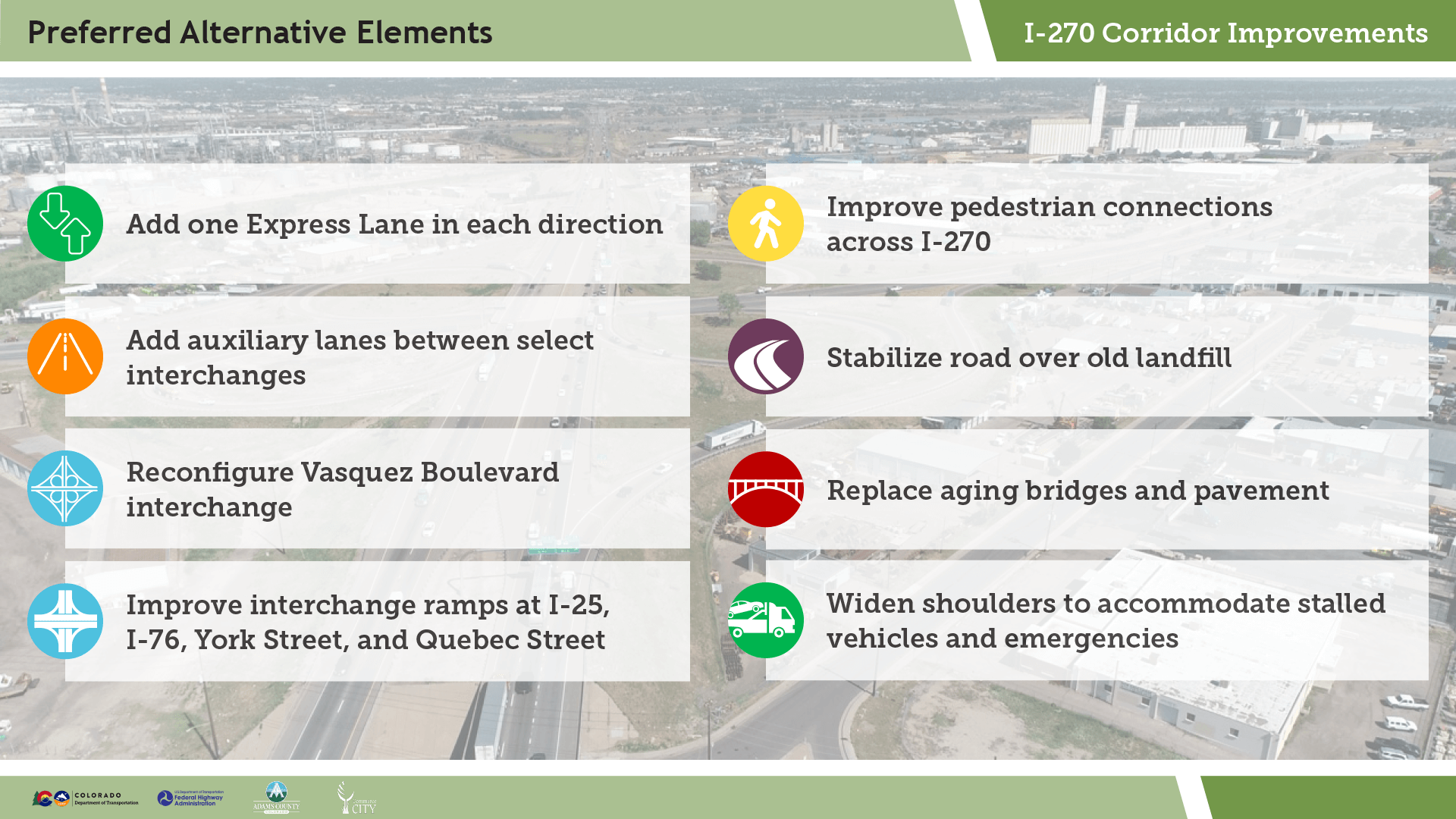

PREFERRED ALTERNATIVE OVERVIEW

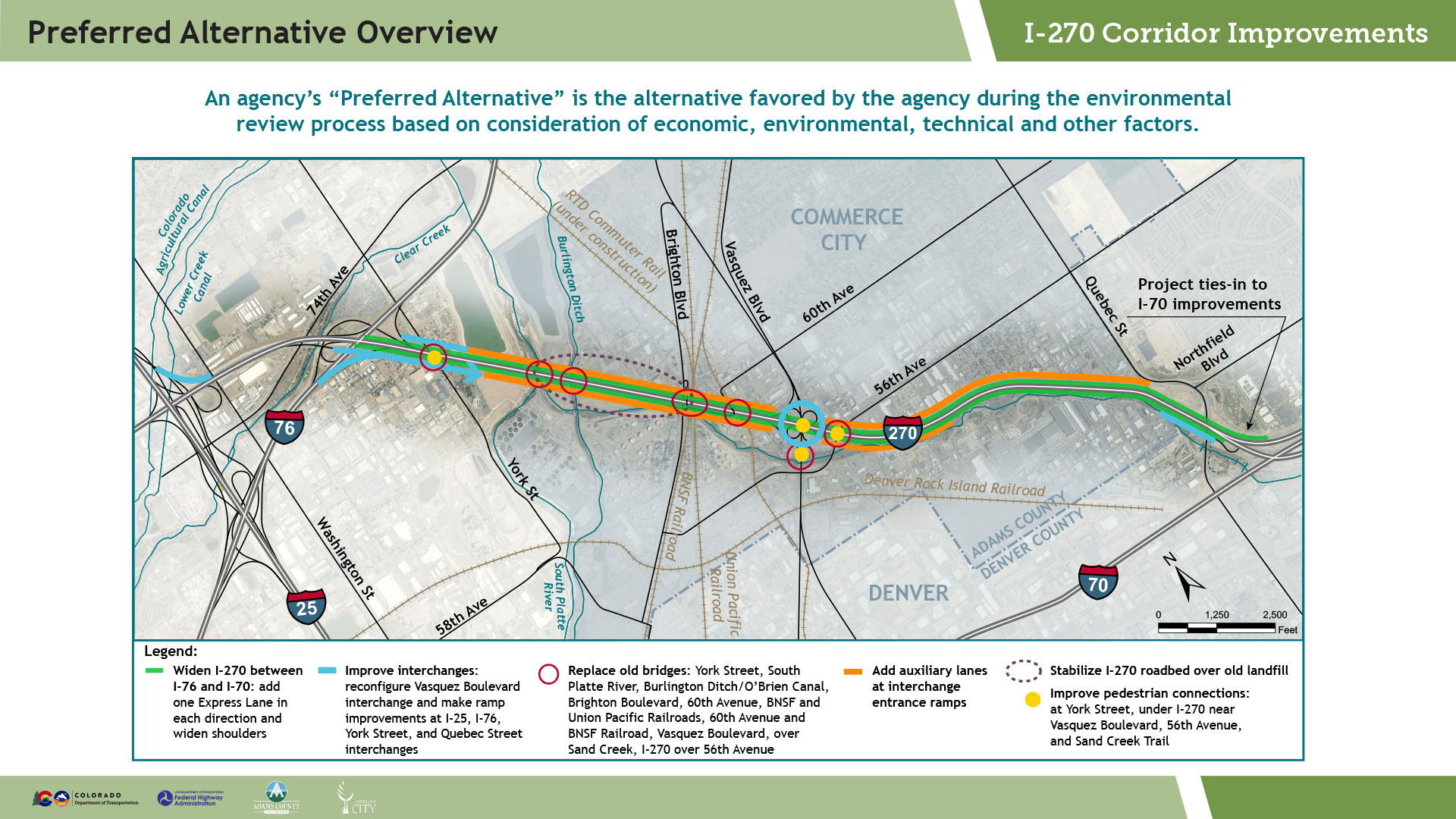

Click on the arrows next to the boards to scroll through the 2 boards in this section.

Enlarge image Click the image above to enlarge.

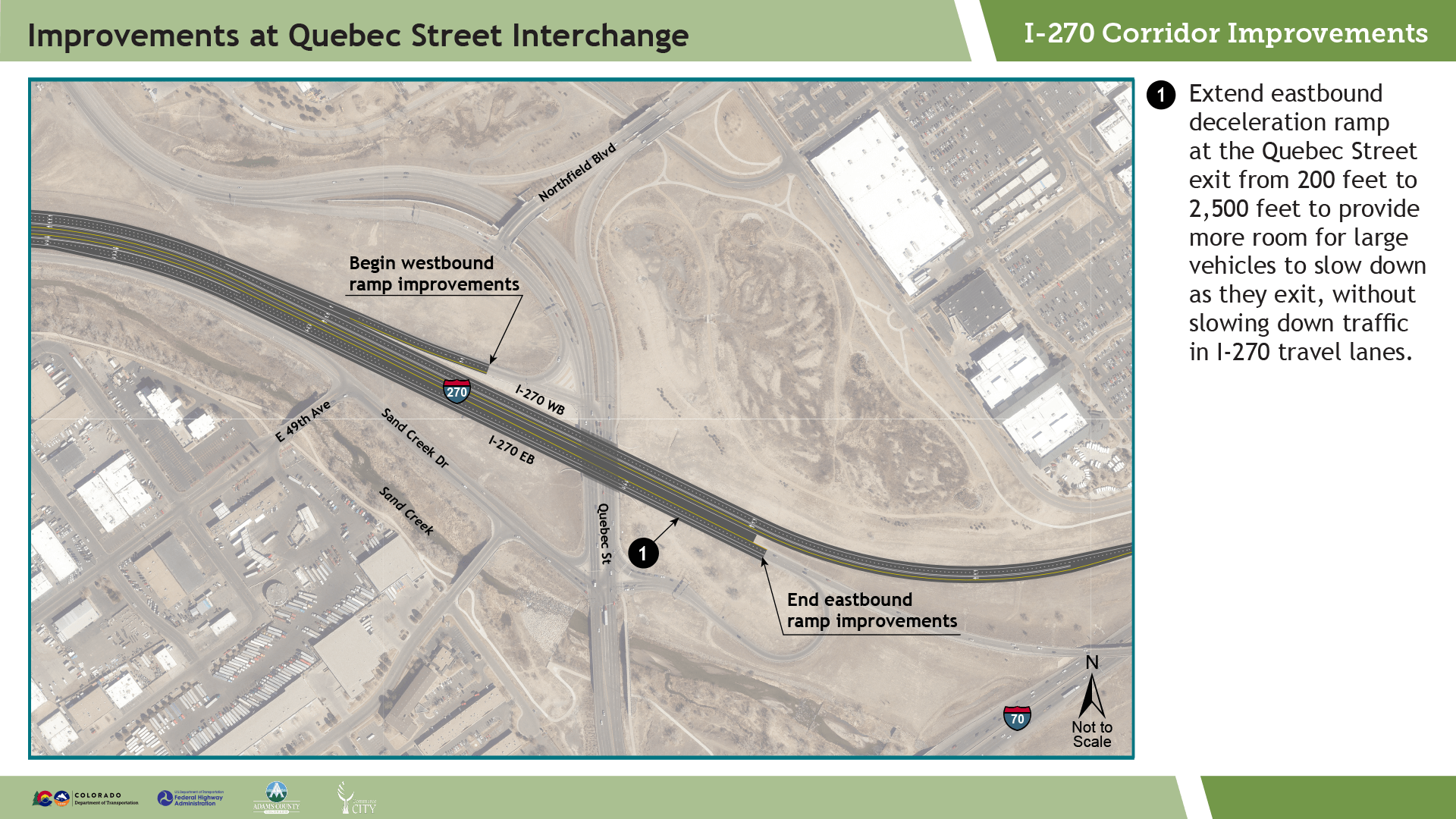

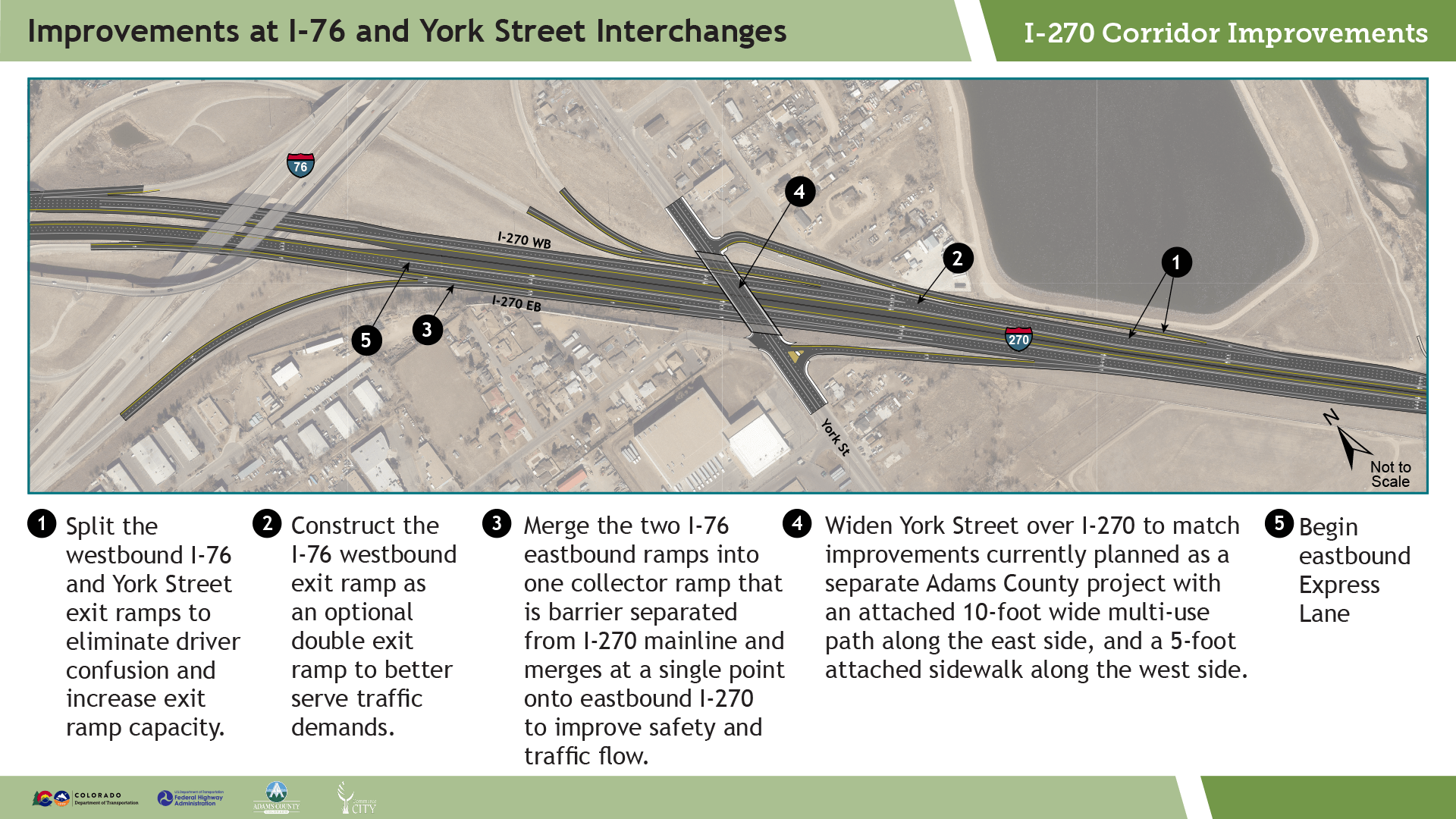

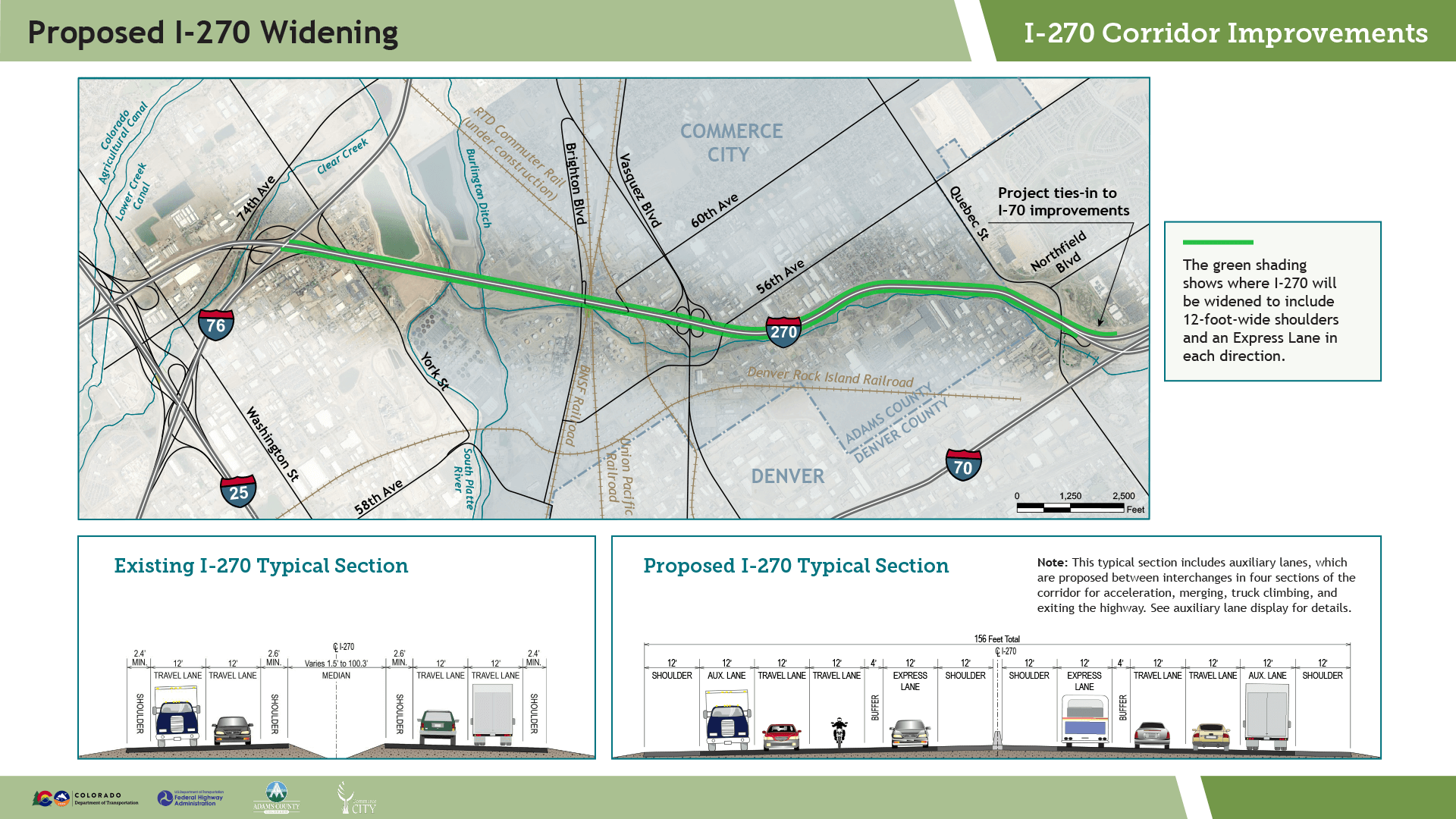

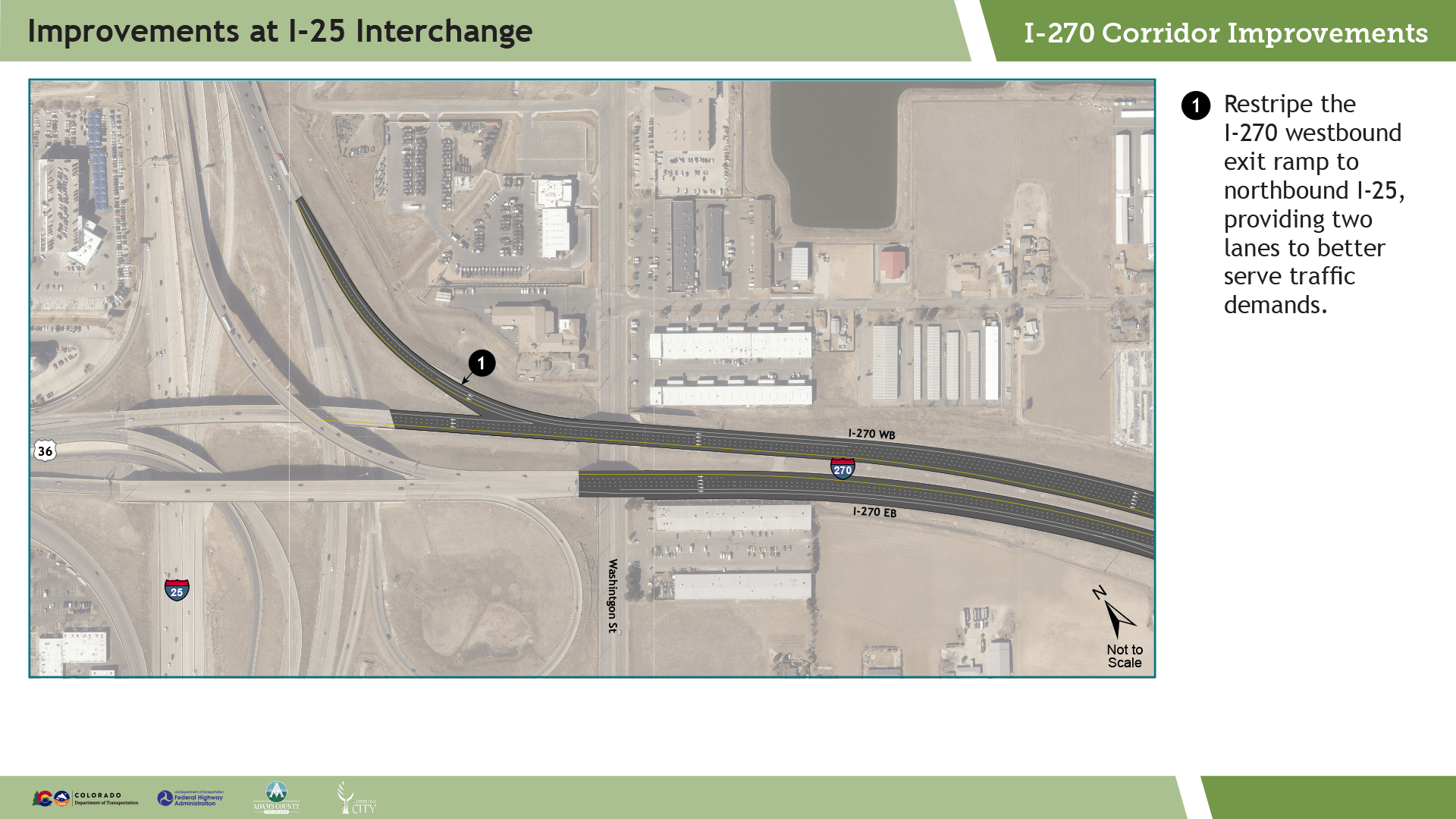

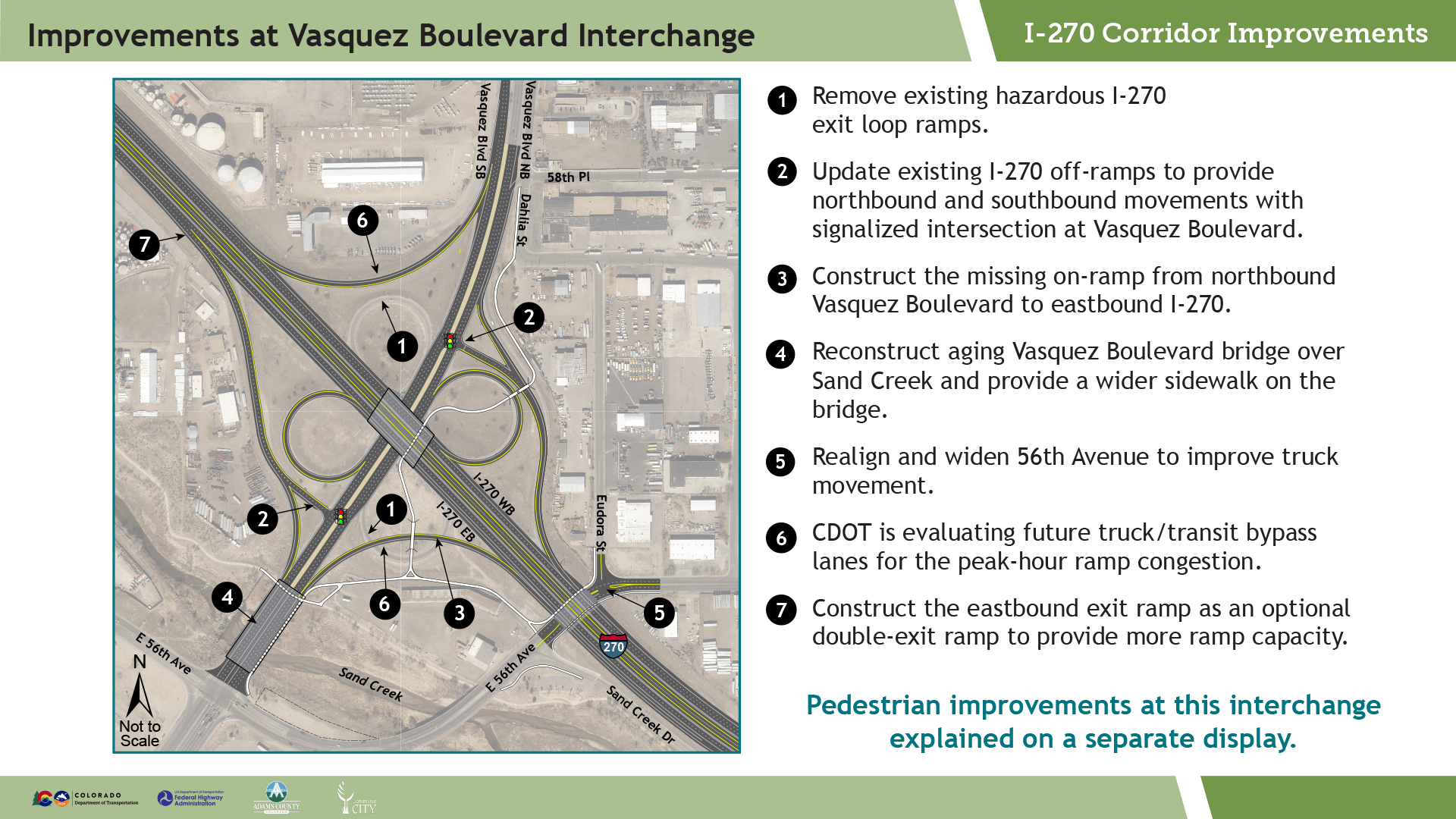

PREFERRED ALTERNATIVE DETAILS

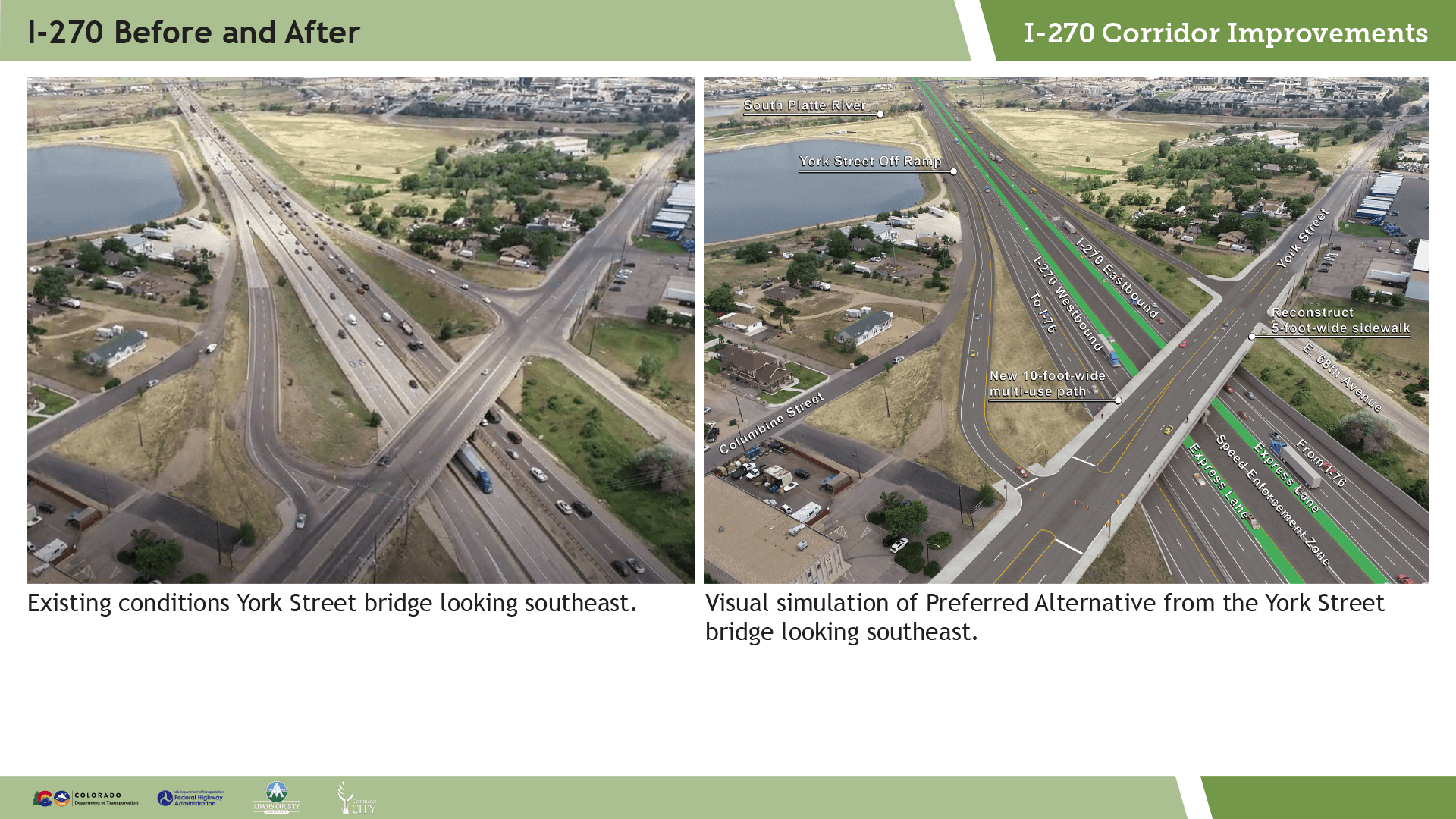

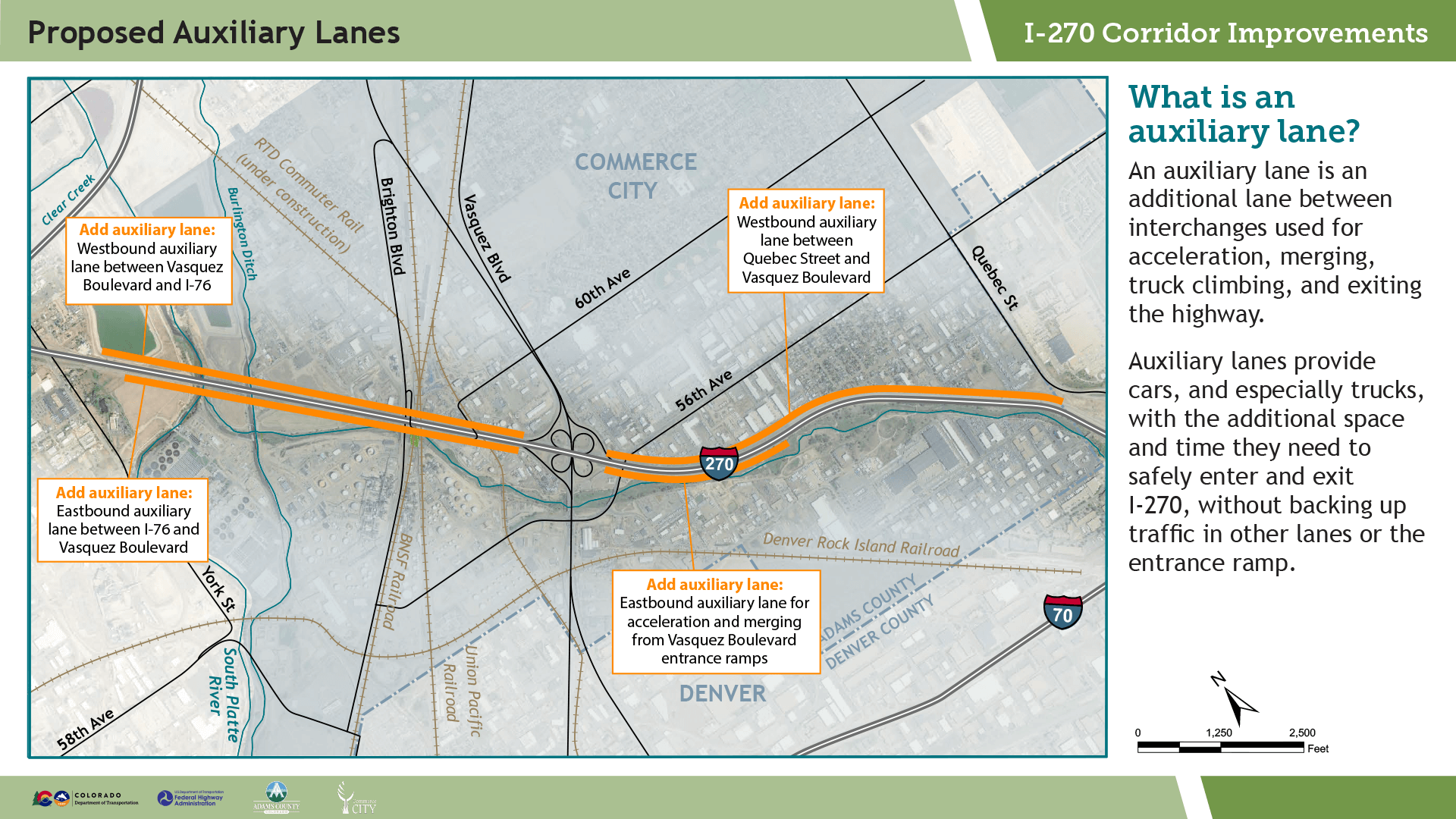

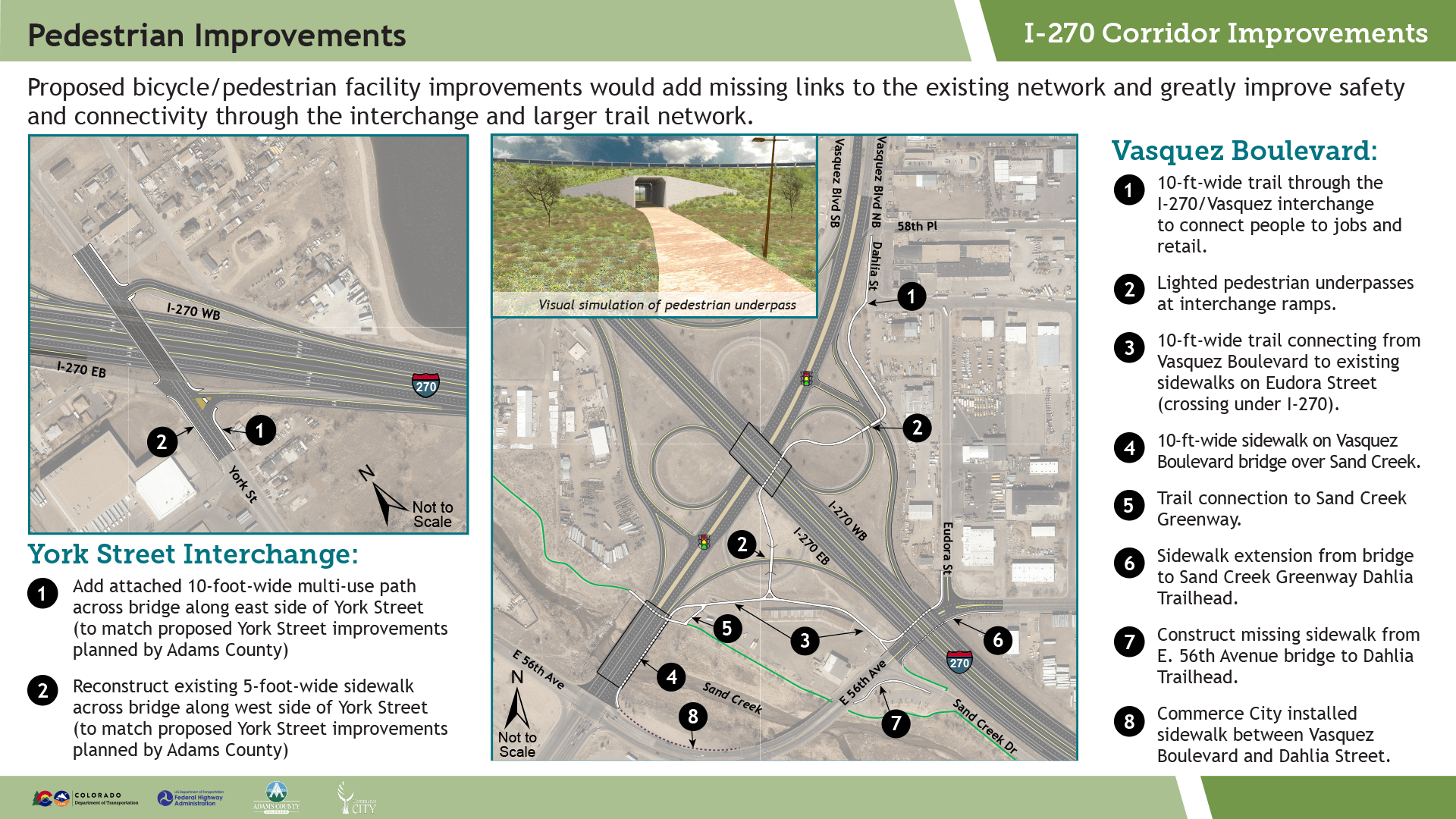

Click on the arrows next to the boards to scroll through the 8 boards in this section.

Enlarge image Click the image above to enlarge.

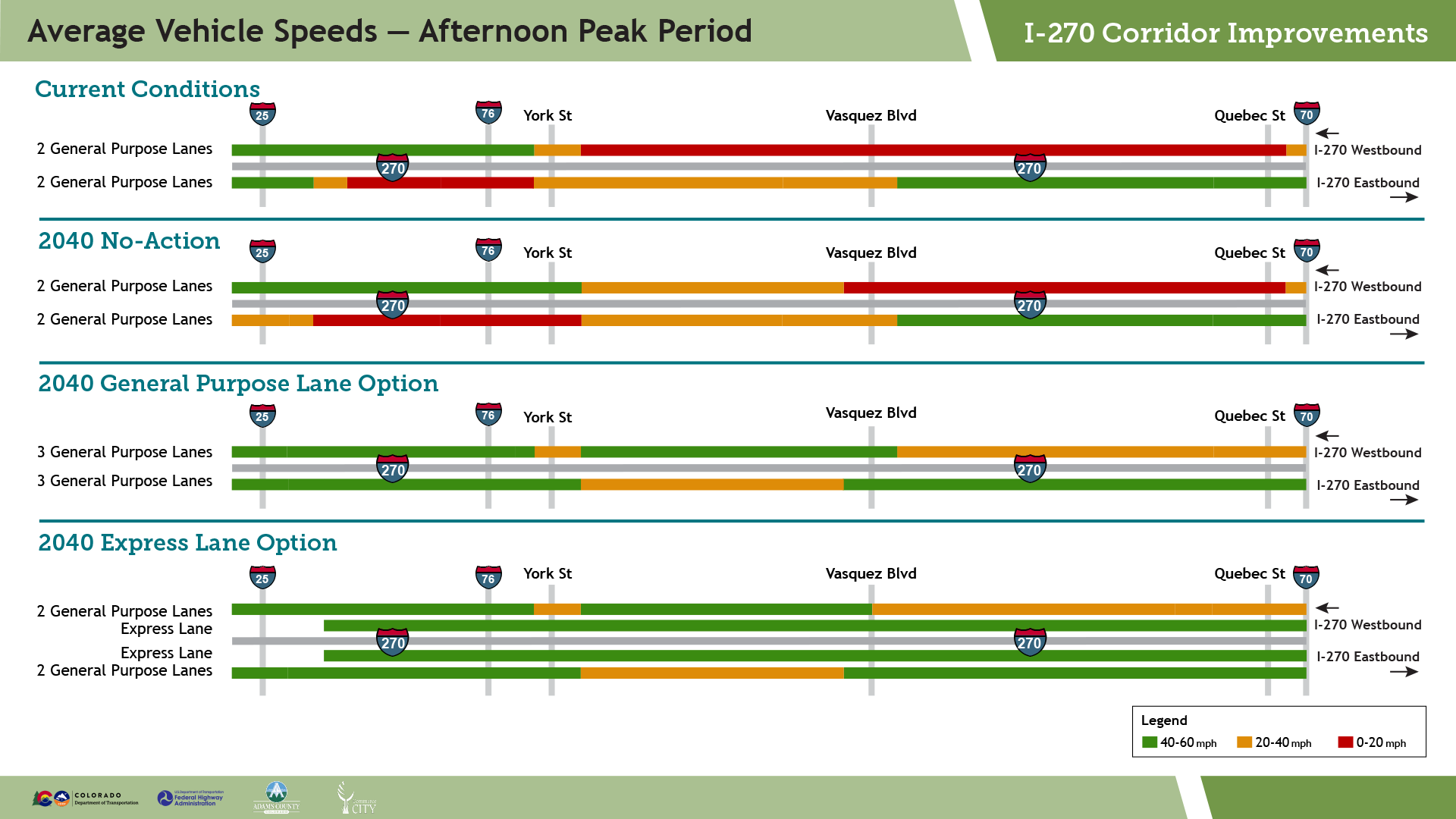

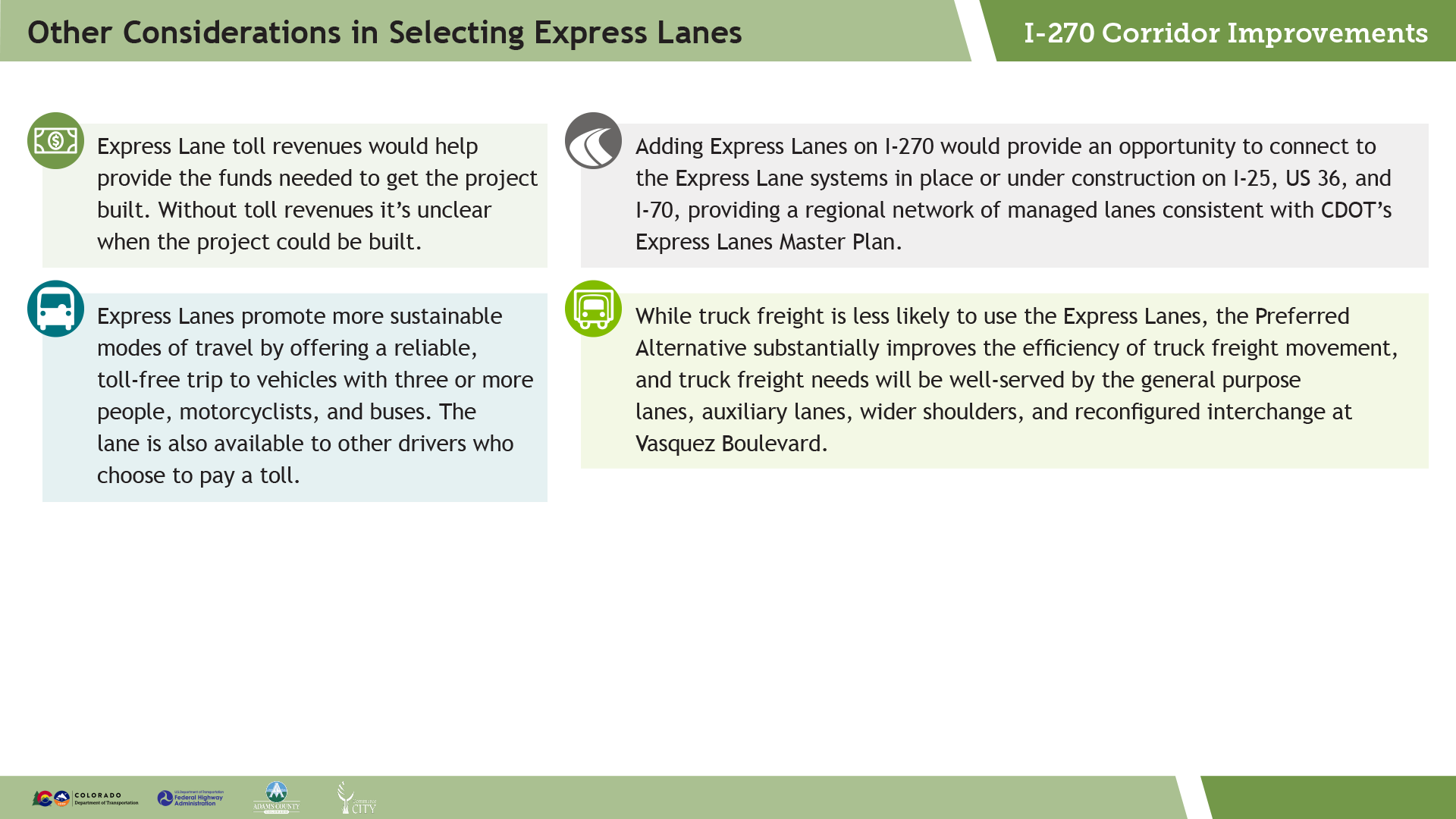

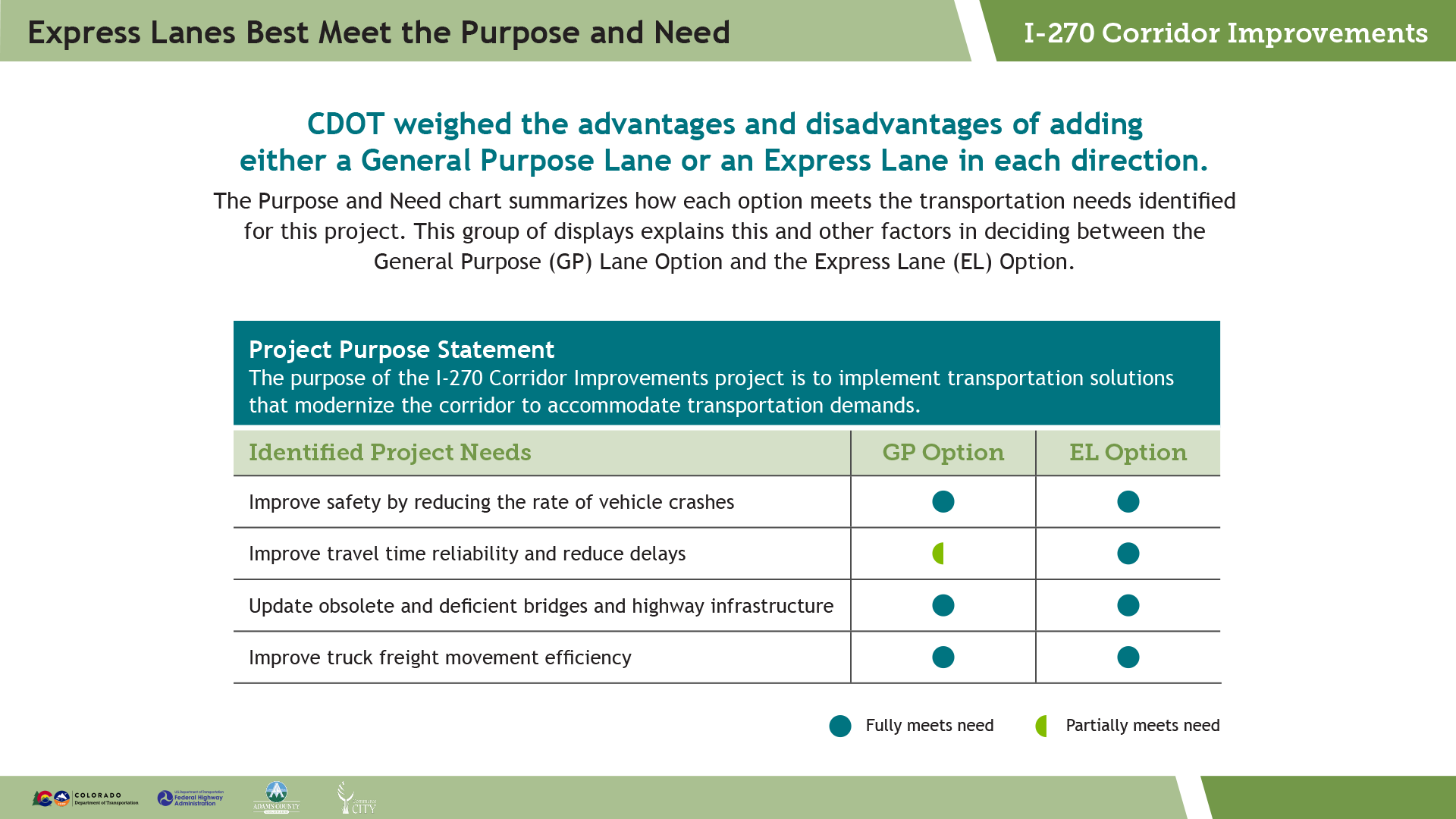

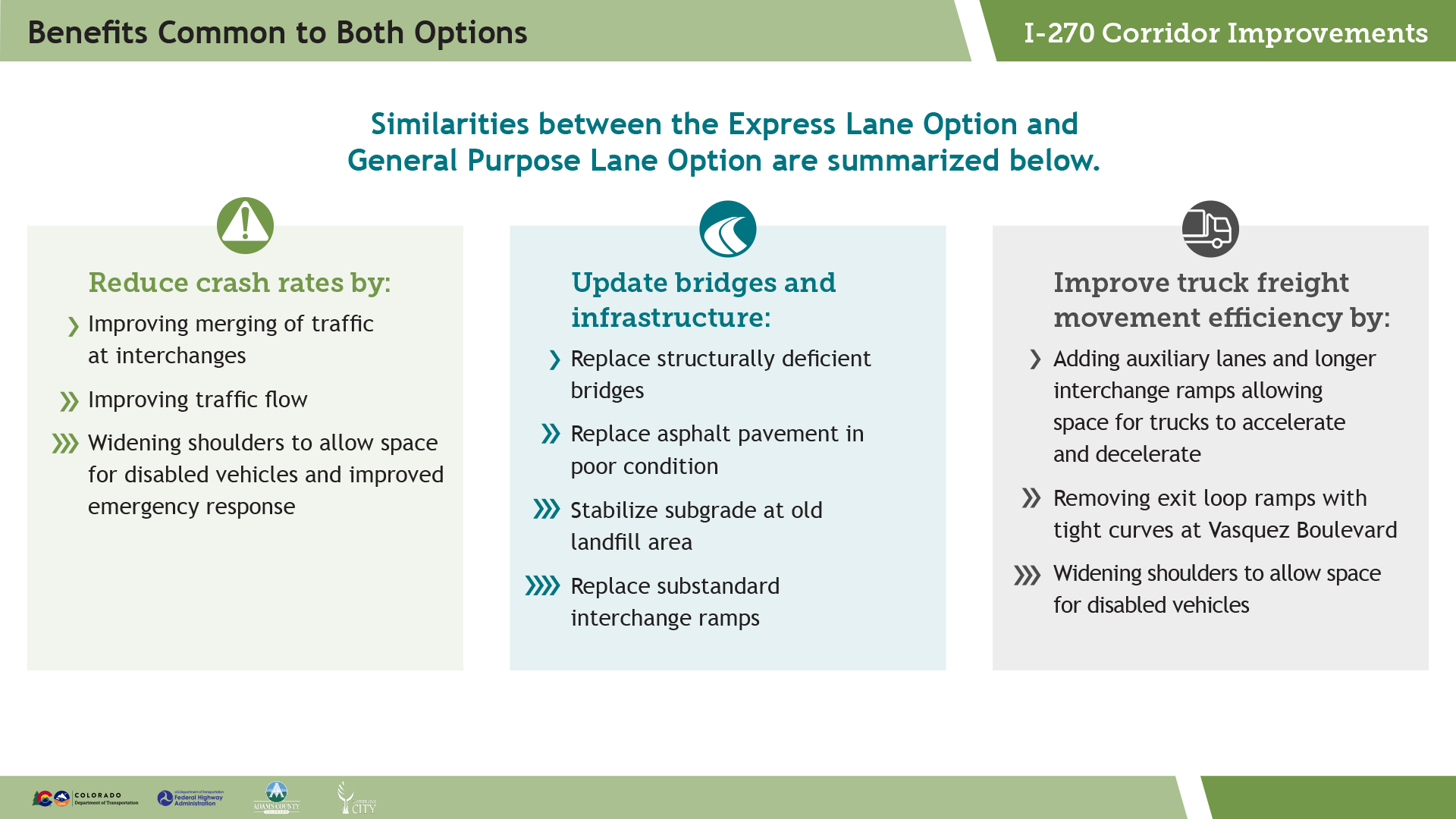

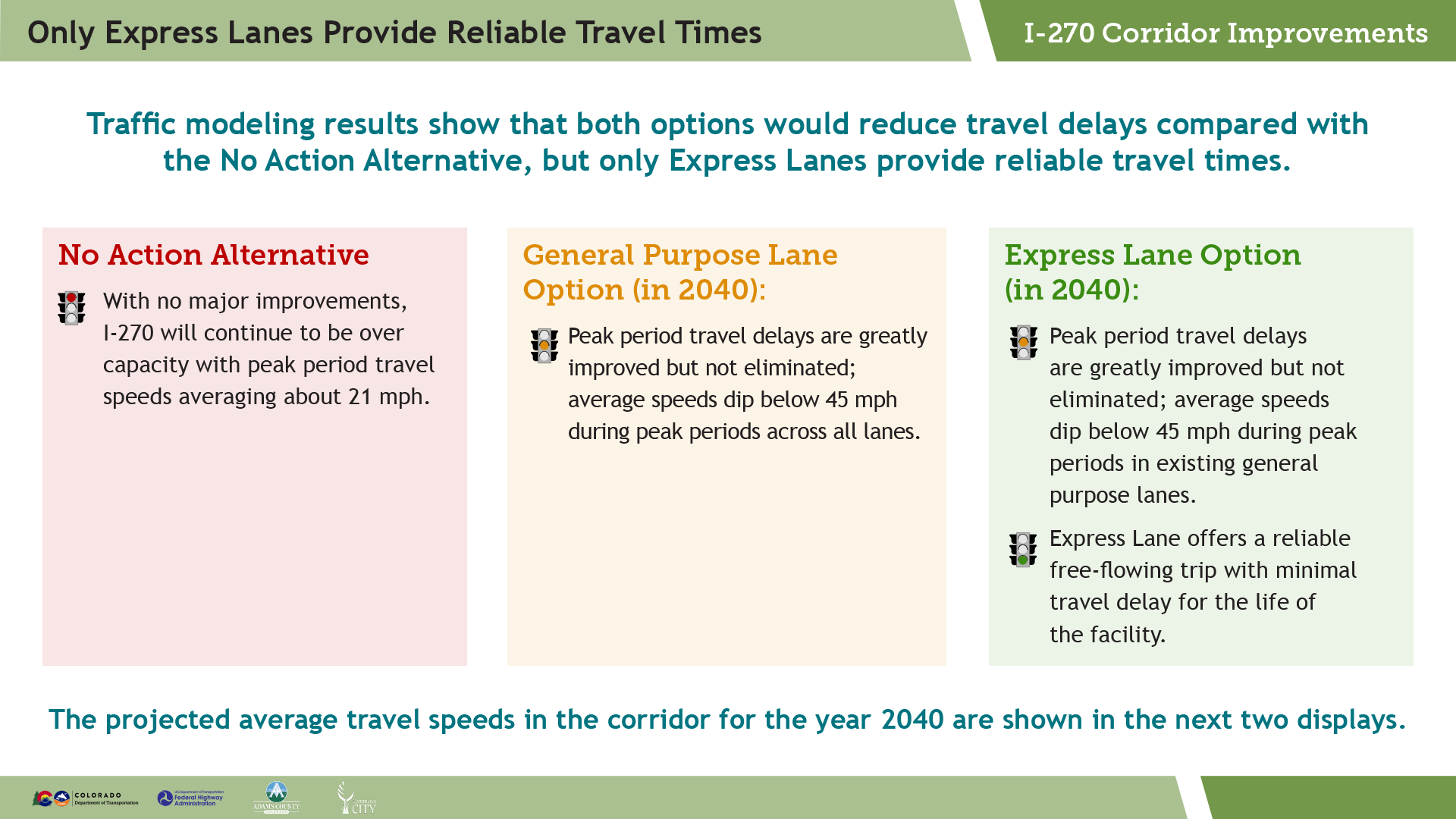

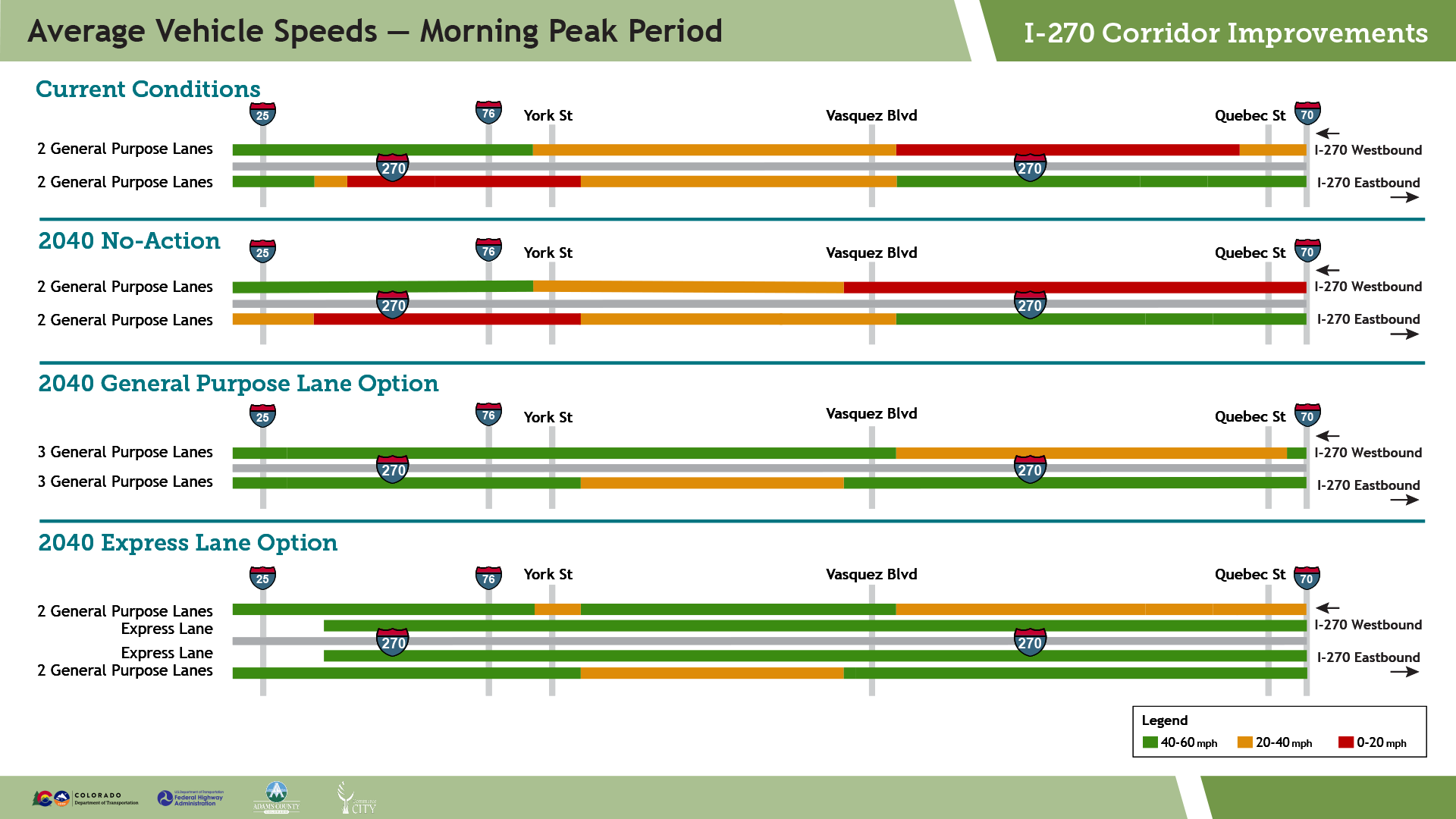

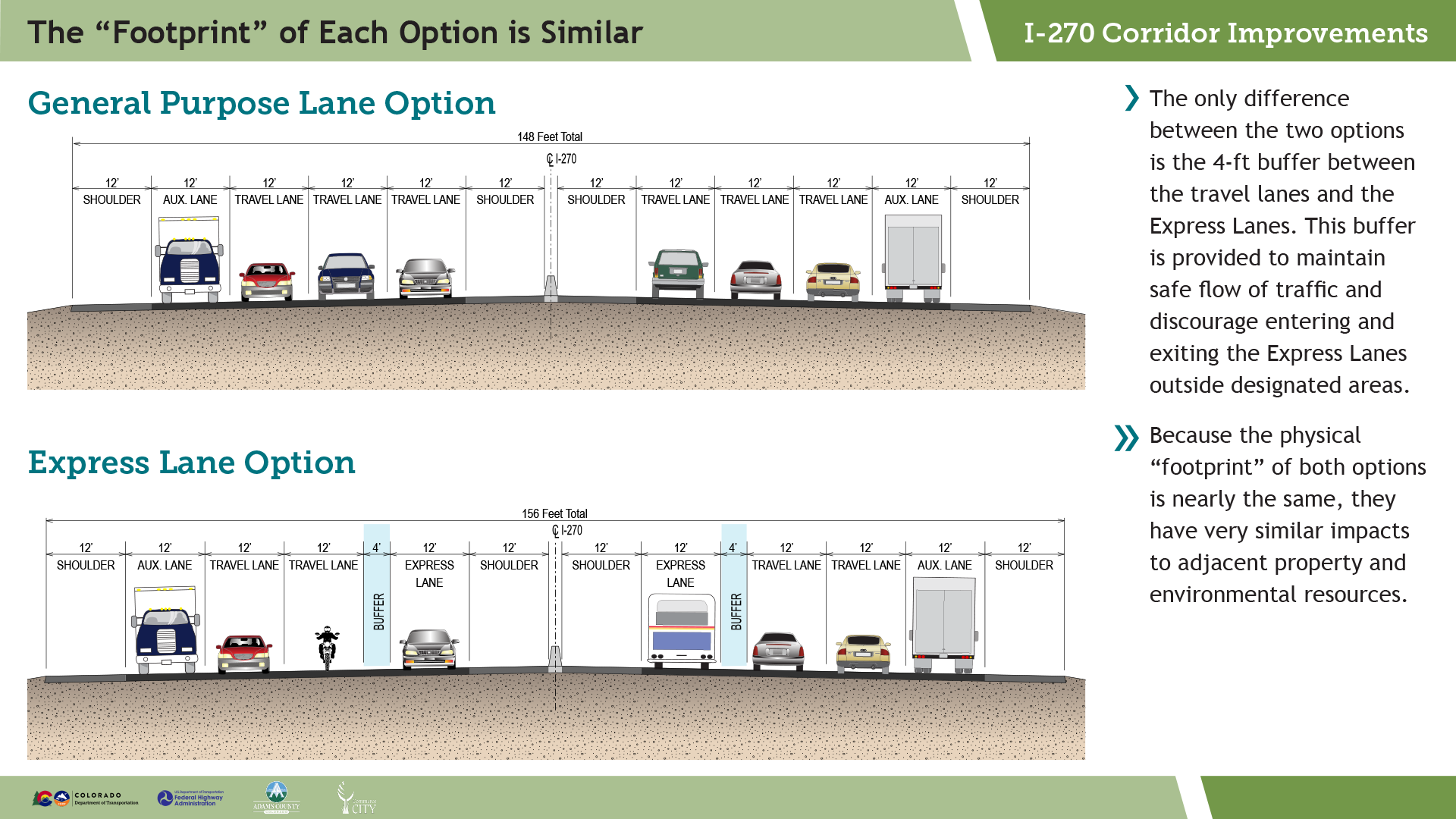

WHY EXPRESS LANES?

Click on the arrows next to the boards to scroll through the 7 boards in this section.

Enlarge image Click the image above to enlarge.

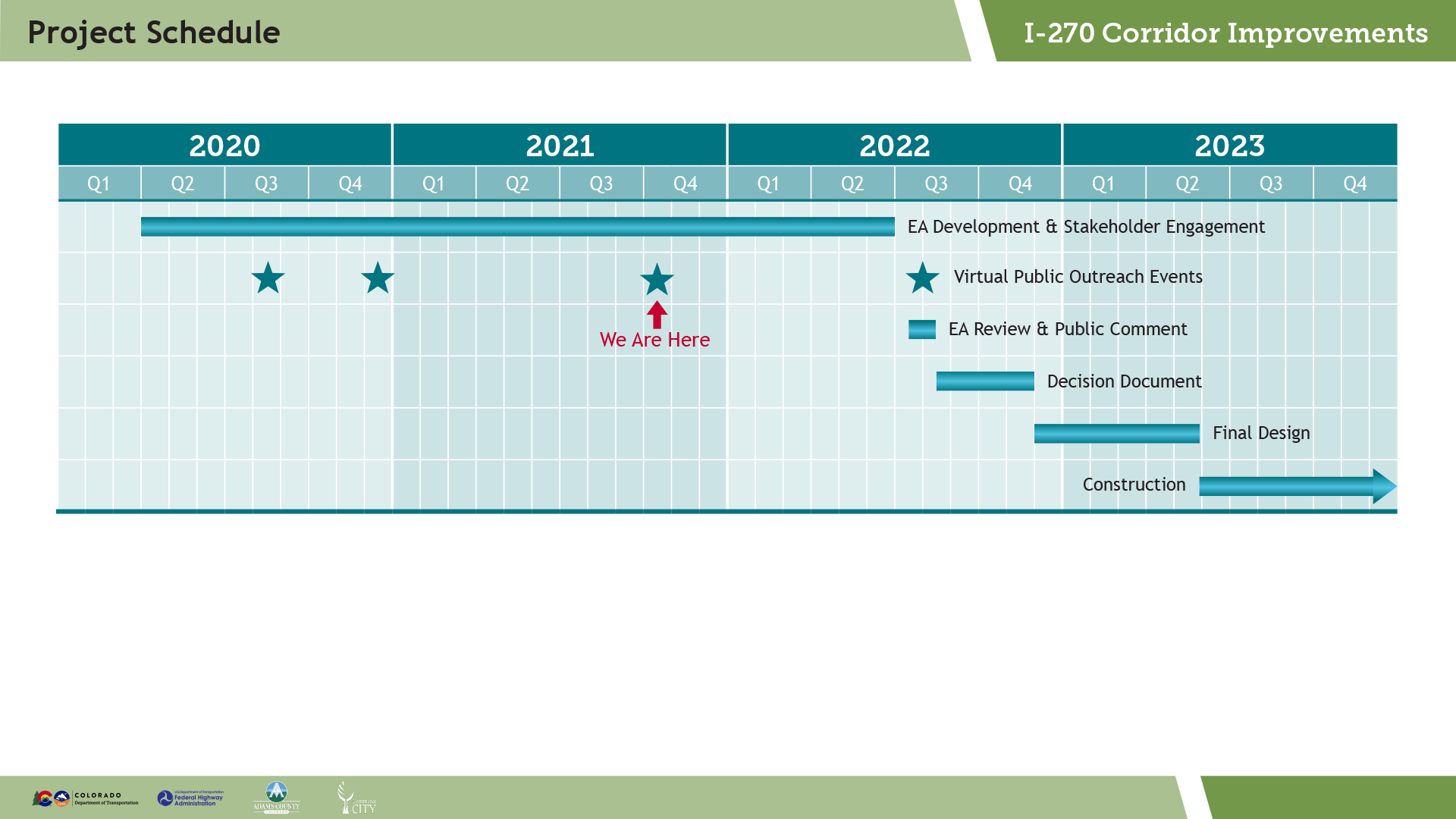

PROJECT SCHEDULE

Enlarge image Click the image above to enlarge.

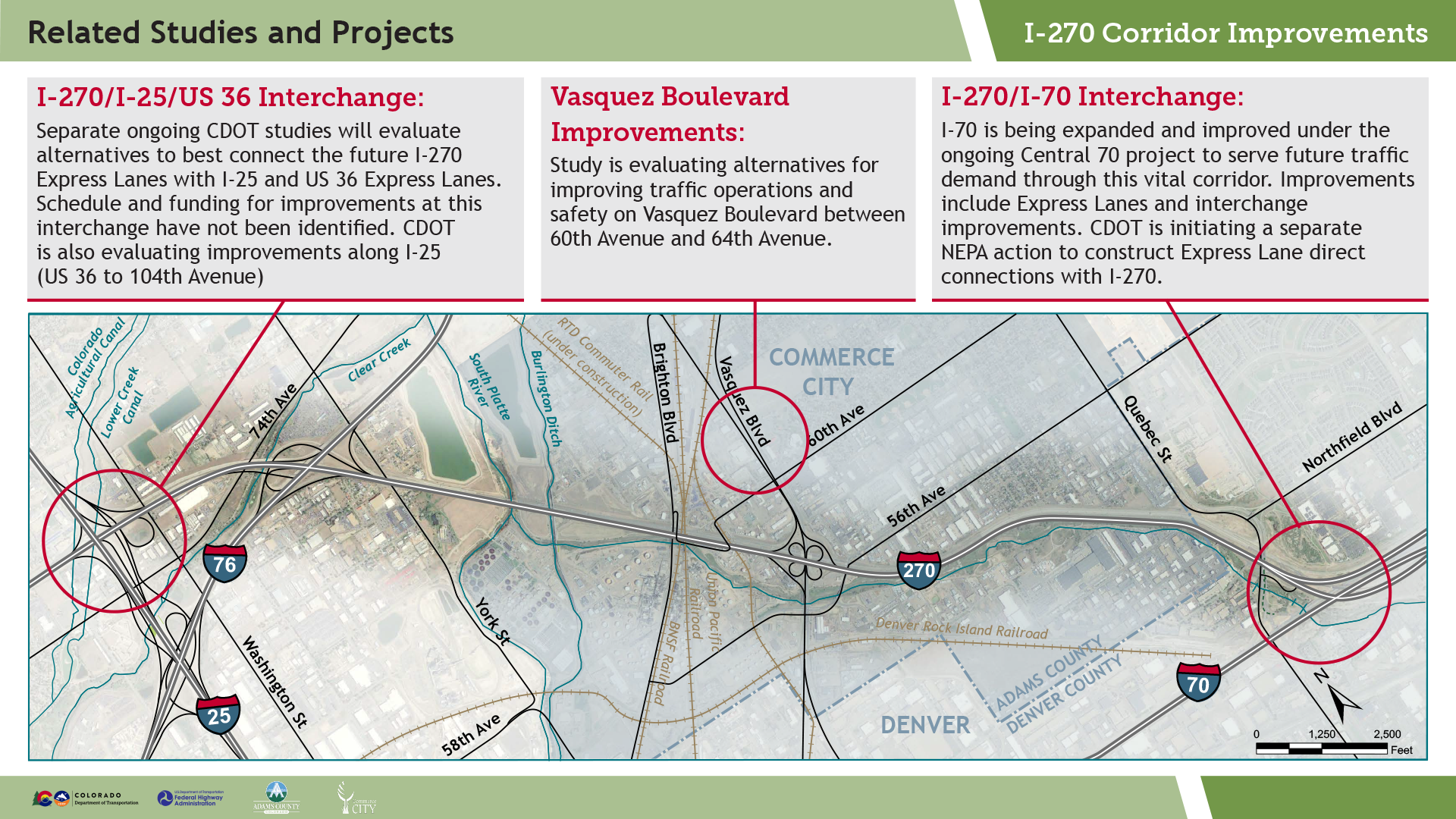

Related Studies and Projects
